Slab Formwork: Methods, QA, and On-Site Checks for Durable Concrete Slabs

Getting slab formwork right is the difference between a flat, durable slab and a costly remedial job. Below is a practical, site-tested workflow you can hand to your foreman and QS—covering setup, QA, and typical pitfalls. Much of this aligns with a classic method statement: rigid, accurately set-out formwork; sound supports; tight joints to prevent grout loss; release agents that won’t stain; and engineer inspection before pour.

What Is Slab Formwork?

Slab formwork is the temporary mould and support system—deck, joists, props/shores, and bracing—that holds fresh concrete until it gains sufficient strength. Good formwork must:

  • Hold line, level, and camber without noticeable deflection.
  • Resist twist/bow and sit on non-yielding supports.
  • Present a smooth, release-treated surface that won’t mark the concrete.

Pre-Pour Sequence (Field-Ready)

  1. Clean & prepare verticals
    Brush walls/columns reinforcement; remove debris at interfaces so slab steel seats properly.
  2. Set out services/ducts first
    Install ducts as per approved shop drawings before placing reinforcement; request engineer check/approval.

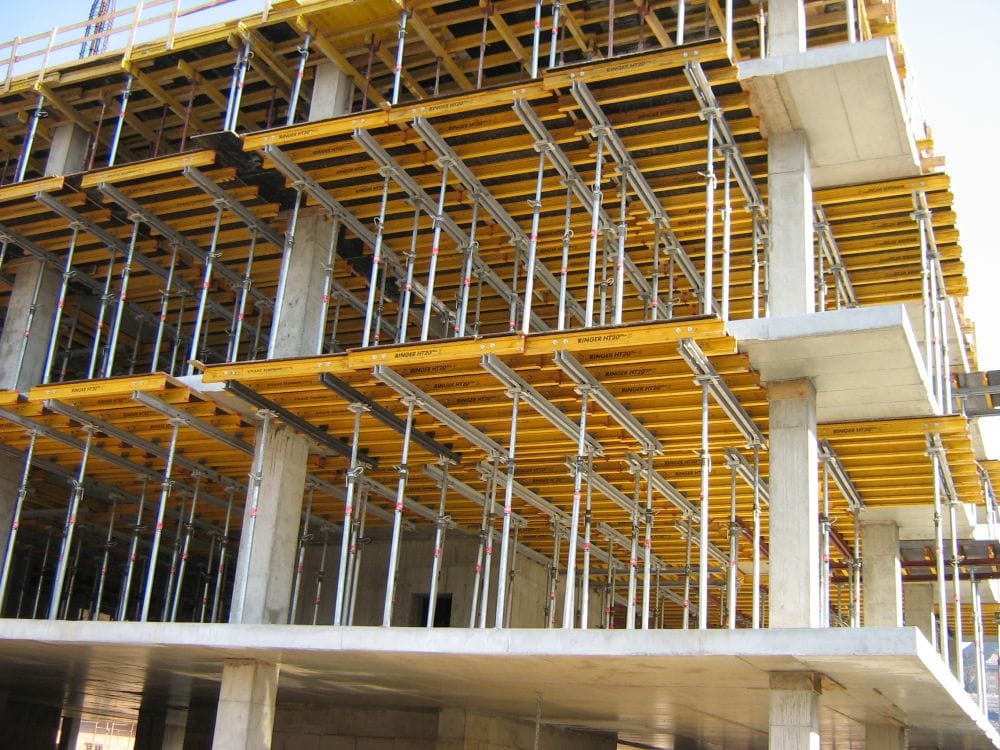

  3. Erect the deck
    Use studs/joists/bracing to the scheme or shop drawings; verify deck thickness and spacing. Keep the form free of twist/bow.
  4. Level & line control
    Check top sheeting levels with an instrument; lock in camber where specified.
  5. Seal joints
    Rigid, tight joints avoid grout loss and honeycombing—critical for durability and aesthetics.
  6. Release agent
    Apply an approved, non-staining release agent uniformly to all contact surfaces.
  7. Engineer inspection
    Request hold-point sign-off on formwork, ducts, and cleanliness before fixing top mesh or pouring.

Materials & Crew

Typical materials: timber/ply deck, nails/screws, steel props/pipes, wire ties, bracing hardware. Execution by skilled carpentry/formwork crew under a site engineer.

Quality Risks & How to Avoid Them

  • Deflection/sag: Undersized joists or sparse shores. Fix: Follow spacing tables, add intermediate props, proof-load/check camber.
  • Grout loss & honeycombing: Gappy joints or poor edge formers. Fix: Tighten joints, use edge tapes/seals, pre-wet timber appropriately.
  • Surface staining: Incorrect release agent or over-application. Fix: Approved, thin, uniform coat only.
  • Level errors: No instrument check. Fix: Mandatory level survey of deck before rebar and again pre-pour.

Handover & Strip

  • Post-pour checks: Finish quality, edges, penetrations, and soffit.
  • Strip criteria: Only when concrete reaches required strength; remove shores in a controlled sequence to avoid early-age cracking and deflection (follow engineer’s temporary works plan).

Site Checklist (Copy/Paste)

  •  Deck erected to drawings; no twist/bow; supports non-yielding.
  •  Ducts/services fixed per approved shop drawings; photographed for records.
  •  Joints tight; edge seals fitted; no visible gaps.
  •  Release agent: approved, uniform, non-staining.
  •  Level survey completed and recorded.
  •  Engineer inspection/hold-point signed off.
